A second source supplier is not a backup you call after the primary line stops. It is a shop you keep warm on real work, so that a breakdown or a capacity crunch does not send you back to first-article approval from zero. Whether that overhead is worth carrying depends on what a missed shipment costs your assembly line, not on a procurement rulebook.
What a Second Source Supplier Actually Solves
Three problems, and little else. Supply continuity when the primary shop loses a machine, loses a programmer or takes on a larger customer. Leverage when a quote has drifted upward for two or three cycles without a change in the drawing. And a sanity check on process assumptions — a second shop that quotes a part in a different way often reveals that the first route was chosen out of habit.
What it does not solve is a quality problem at the primary. If parts fail because the process is not capable, a second shop doubles the number of processes to watch. Fix capability first, then decide whether a second source is still needed.
When Dual Sourcing Is Worth the Overhead
Run the arithmetic on the part, not on the supplier list. Dual sourcing tends to pay for parts with a long tool or fixture lead time, parts that stop a line when they are missing, and parts where only one process route is practical. There the qualification cost is a one-time premium against a larger loss, and some buyers formalize it as a capacity reservation agreement.
It tends to lose money on low-volume brackets, prototypes and anything a general job shop can quote in a week. For those, a spot quote from a second shop is enough — you keep an approved alternative without funding duplicate tooling.
A workable screen: if a three-week interruption means rescheduling assembly and calling customers, the part belongs on the dual-sourcing list.
What Qualification Actually Costs
Supplier qualification is the line item most often left out of the business case, and it is usually the largest one. The first order from a new shop is not free capacity — it is an engineering project with a delivery date.
| Cost item | What it covers |
|---|---|
| Sample run | First-off parts, material certificates, a dimensional report |
| First article inspection | Ballooned drawing, measured features, documented acceptance |
| Duplicate tooling | Fixtures, soft jaws, programs and probing routines |
| Administration | NDA, quality agreement, packaging and labeling instructions |
The tooling line is where budgets surprise people. A part already running at the primary source usually has fixtures amortized long ago; the second source has to build its own, and that cost lands on the first order. It is fair to ask whether that tooling belongs to you, since you are paying for it — a point that also matters for tooling ownership and file control when the relationship ends.
How to Split the Award Without Losing Leverage
A 50/50 split feels even-handed and usually performs poorly. Neither supplier gets enough volume to keep the process stable, and neither has an incentive to hold the price. Splits in the 70/30 to 80/20 range keep a clear volume holder while giving the alternate enough work to stay familiar with the part.
Give the second source a repeating part family rather than leftover quantities. A supplier that sees the same part every month will hold the setup, keep the fixtures on the shelf and notice when a dimension starts to drift. One that sees it twice a year treats every order as a new job.
Review the split award on a fixed cycle, and move volume when performance justifies it. A split that nobody revisits quietly becomes a single source with extra paperwork.
Keeping Two Suppliers From Doubling Your Administration
Two suppliers running from different assumptions is the most common failure mode. The drawing revision, the acceptance criteria and the measurement method have to be identical — one controlled copy at both sites, with a change notice that reaches both.

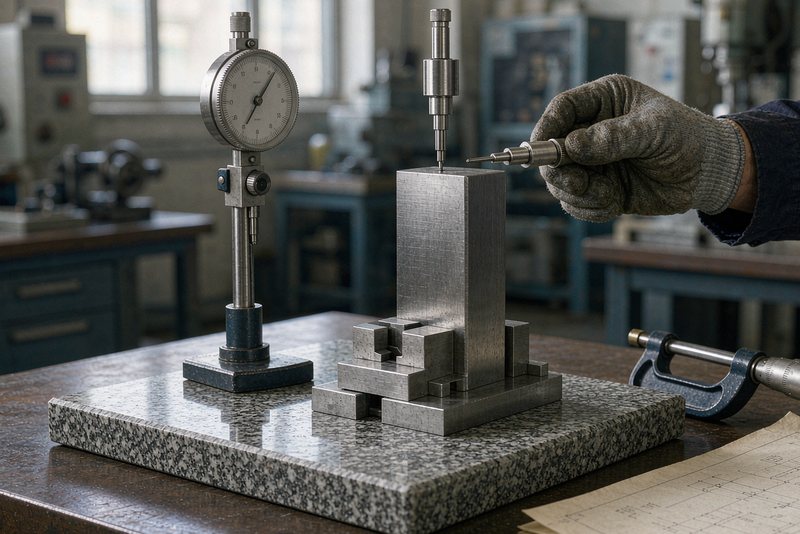

Acceptance should follow the same procedure on both sides. A first article inspection with a ballooned drawing and a measured report gives you a baseline you can compare between shops; verbal confirmation that the part is "to print" does not.
Non-conformances should also run through one process, so that a deviation from either supplier is dispositioned the same way. The structure of a non-conformance report matters less than applying it consistently.

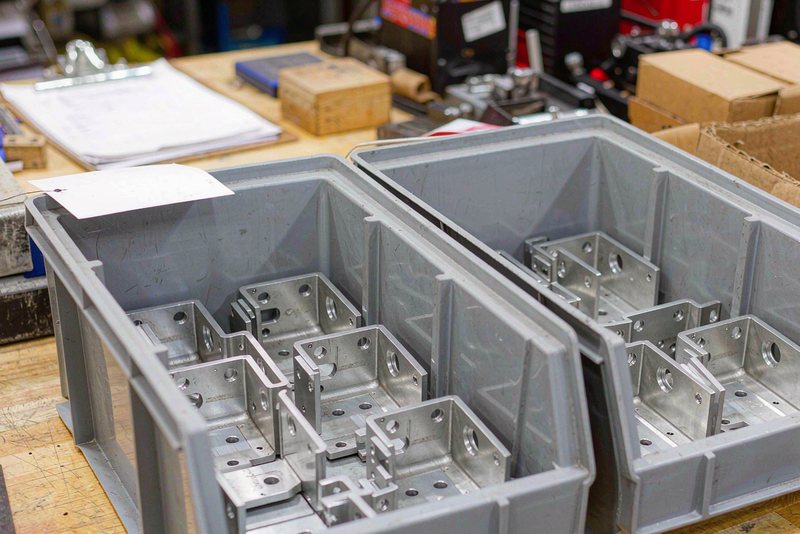

Keep lots separated in receiving and in stock. Mixed lots from two sources are hard to trace back if a field failure appears a year later.
Mistakes That Turn a Backup Into a Liability
- Qualifying a supplier on a one-off order, then sending nothing for a year. The process knowledge is gone; the approval on paper is worthless.
- Letting the second source work from an older drawing revision because "they already have the file".
- Splitting volume so thin that neither shop runs the part often enough to hold tolerance on selected critical features.
- Choosing a second source on price alone when the reason for having one is delivery risk.
The last point erodes a sourcing plan slowly. A cheap alternate that cannot hold the drawing is not a backup; it is a second problem.
When to Drop the Second Source
Maintaining an approved alternate is not free. If a supplier has failed two consecutive qualification attempts, or the part is heading for a redesign, the money is better spent elsewhere.
There is a middle option that most buyers overlook: keep the backup supplier approved and dormant, with a current drawing on file and no open orders. That preserves the option to reactivate without carrying the cost of a live split. For parts with a long service life, lead time exposure is usually the deciding factor in whether dormant is enough.
The Decision in One Paragraph
A second source supplier earns its place when a supply interruption would cost more than a qualification program — typically on long-lead, line-stopping parts where duplicate tooling is a known number rather than a guess. Qualify with a real first article, split the award roughly 70/30, keep both shops on one drawing and one acceptance standard, and review the arrangement on a schedule instead of waiting for a crisis. When the arrangement stops paying for itself, retire the second source supplier deliberately rather than letting it decay.
